DC3 Hall3 Update

A month later and work on hall 3 in DC3 is progressing well. We've installed the internal air con CRAC units into the hall and completed all the internal pipework. The internal electrical installation is now complete along with air extract systems for the gas suppression system.

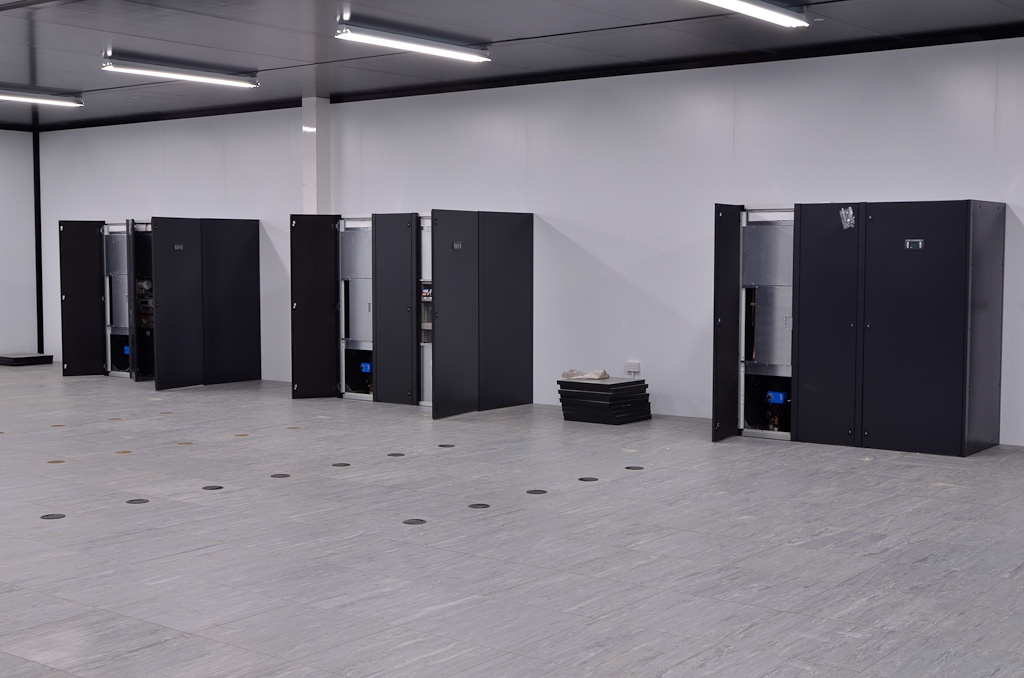

DC3-11

Next week we will take delivery of our Chillers and connect these to the 2 water tanks outside the DC. Once this is connected, we can pressure test the system and fill it with water / glycol mix ready for commissioning.

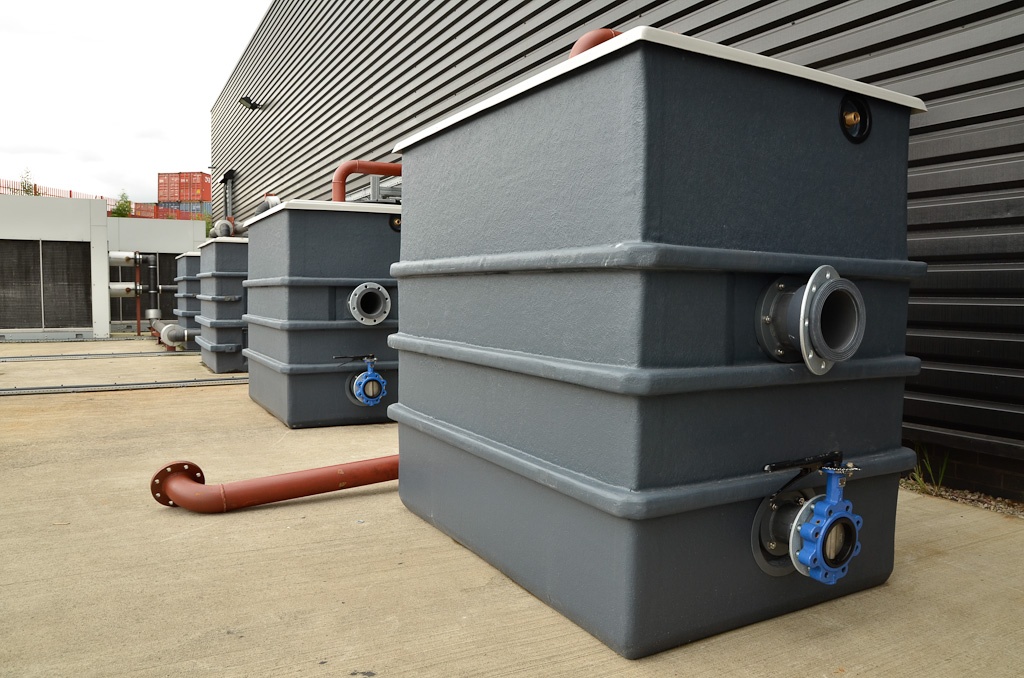

DC3-3

Still to do is the Gas Suppression system (IG55 Argon / Nitrogen) and VESDA and installation of security systems (swipe card access and CCTV cameras). All on track for 1st September opening!
